Most companies looking for a Zuora implementation partner are really buying two different things. The first is the configuration of Zuora itself – the product catalog, rate plans, billing rules, invoice templates, payment runs and revenue settings. The second is everything Zuora has to agree with, from the CRM where deals are quoted and the product systems that generate usage, to the payment gateway and the general ledger where finance closes the books.
Those two jobs call for different skills. When one firm is expected to do both, the integration work is usually the part that gets underestimated, and it’s usually also the part that decides whether the go-live date holds. This article sets out where the line between the two falls, what each kind of partner should own, and how to scope a Zuora program so that the space between them has an owner.
Why billing is unforgiving
A billing integration is visible to three audiences at once. Customers see it on their invoices, finance sees it at month-end, and the auditors see it when revenue is tested. In most systems, a defect produces a bug report. In billing, it produces an incorrect invoice, a credit note, a reconciliation exercise and, once in a while, a restatement. That’s why the integration layer around Zuora deserves at least the same engineering discipline as Zuora’s own configuration, and often more.
What a Zuora implementation partner owns
A good implementation partner knows Zuora deeply and works mostly inside it. Its responsibilities usually start with the product catalog and pricing design, so that the products, rate plans, charge models, discounts and bundles reflect how the business actually sells. It configures the subscription lifecycle – new subscriptions, amendments, renewals, upgrades, downgrades and cancellations – and it sets up billing and invoicing, which covers bill runs, invoice templates, taxation, payment terms and dunning.
When Zuora’s revenue capabilities are in scope, the implementation partner also configures the recognition rules and policies that finance has agreed to. It builds workflows and reporting inside the platform, and it designs the processes, and provides the training, that the billing and finance teams will need in order to run it. This is specialist platform work, and it’s where the implementation partner’s certification and product knowledge earn their fee.

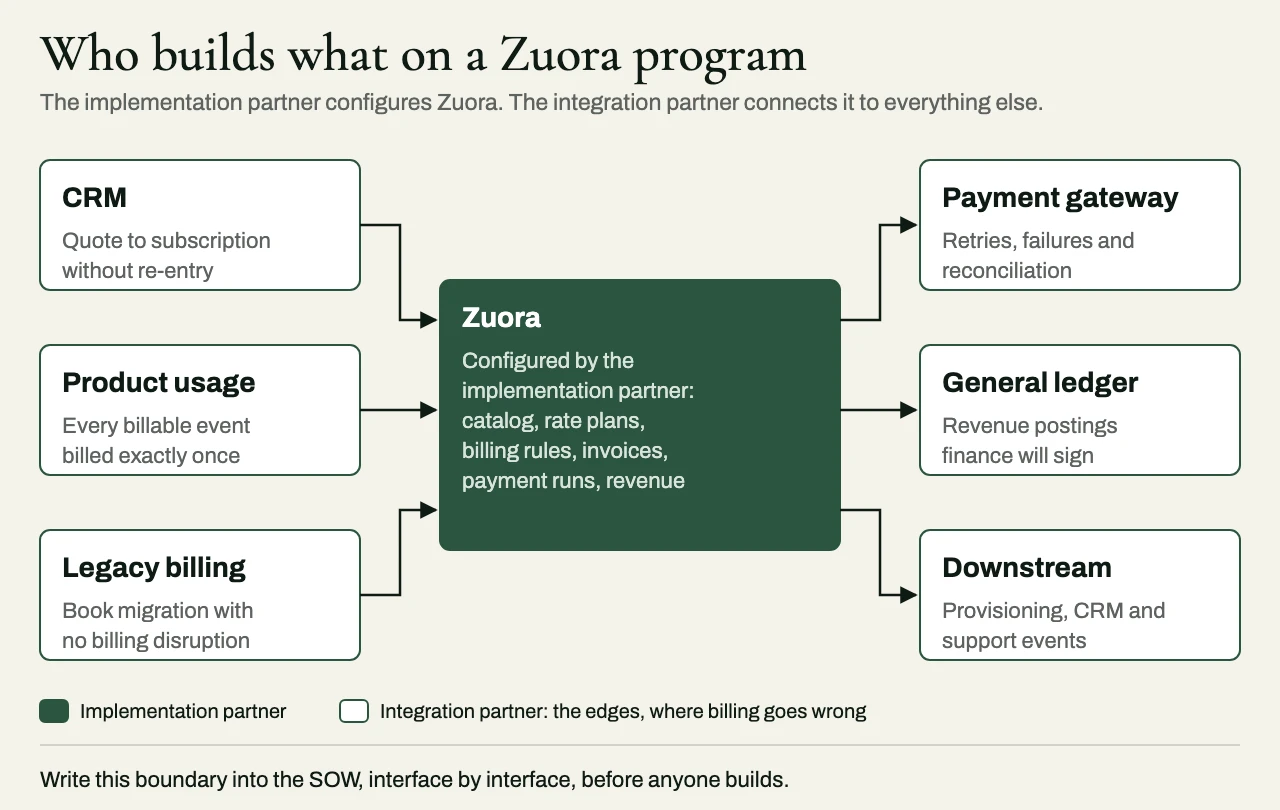

What an integration partner builds
An integration partner works on the other side of that boundary, building the connections between Zuora and the systems that either feed it or depend on it.
| Integration | What it involves | Why it is hard |
|---|---|---|
| Quote to subscription | Turning a closed deal in the CRM into a Zuora subscription, with no re-entry | Product and price mapping, amendments to existing subscriptions, and keeping the CRM and Zuora in agreement after the deal closes |
| Usage-based billing | Feeding usage from product telemetry into Zuora on schedule | Volume, late and duplicate events, and proving that every billable event was billed exactly once |
| Payments | Gateway integration, payment status and the handling of failed payments | Retries, partial failures, and reconciliation between the gateway, Zuora and the bank |
| Revenue and GL | Posting billing and revenue output to the general ledger | Account mapping, aligning periods, and a reconciliation finance is willing to sign |
| Downstream events | Reacting to billing lifecycle events in provisioning, CRM or support systems | Ordering, retries, and never acting twice on the same event |
| Book migration | Moving an existing subscription book into Zuora | Doing it without disrupting billing runs or changing what customers are charged |
The interfaces differ from job to job. Transactional work goes through Zuora’s REST and object APIs, where idempotency has to be taken seriously. Downstream reactions use Zuora’s events and callouts, and bulk extraction for reporting and reconciliation is better served by its bulk data query options than by thousands of individual record calls. Picking the right interface for each job is a design decision in its own right, and it deserves to be treated as one.
Zuora’s product names and packaging change from one release and edition to another. Check specific capabilities against the client’s tenant.

Where Zuora programs actually fail
When a Zuora program slips, the cause is seldom the design of the rate plans. Far more often, it lies in the work around Zuora.
Usage is the classic example. A usage pipeline that behaves perfectly in testing meets real production traffic, along with retries and events that arrive late. Without idempotent processing, some customers get billed twice and others not at all, and nobody can prove which is which. Quotes and subscriptions drift apart in much the same way – after the first amendment, the CRM says one thing and Zuora says another, and the sales team stops trusting either of them. The general ledger feed may not reconcile, with billing totals and ledger totals disagreeing in a way nobody notices until the first month-end close after go-live. And the migration of the existing subscription book is too often treated as a data load, when it’s really a billing event, in which charge dates, proration, open invoices and payment methods all have to land exactly right, and the cutover has to avoid a bill run.
Underneath most of these problems is a single organizational failure, which is that nobody owns the boundary. The implementation partner assumes the client’s IT team will handle the integrations, the client assumes the partner will, and so the integrations start late and become the critical path.
Scoping the boundary in the SOW
The simplest way to avoid a boundary with no owner is to name it in the statement of work, one integration at a time. For each integration, the SOW should record which system is the system of record for every relevant object – account, contract, price, subscription, invoice or payment. It should say who builds the integration, who tests it and who supports it after go-live, and it should define acceptance criteria that include reconciliation, spelling out which totals must agree, between which systems, and for which period. It should describe how failures are handled, so that everyone knows what happens when a call fails halfway through, an event arrives twice or a period is reopened. And it should include the cutover plan, explaining how the migration will avoid a bill run, and how it would be rolled back.
If any of those sections can’t be filled in yet, the integration hasn’t been scoped yet, and it shouldn’t be priced as fixed scope until it has.
Choosing partners for each side
When you’re assessing an implementation partner, it’s worth asking how many Zuora implementations of a similar billing model it has delivered, who designs the catalog, how pricing changes are tested before they reach customers, and – most important of all – what it expects the client, or some other firm, to build.
An integration partner deserves a different set of questions. How does it make sure that each usage record or payment event is processed exactly once? How does it prove that Zuora, the gateway and the ledger reconcile – can it show you a report, or only give you its word? Has it migrated a live billing book before, and how did it avoid disrupting the bill runs? And does it run a Zuora practice of its own? That last question matters more than it seems to. An integration partner that also sells Zuora implementation has a reason to expand into the platform work, while one that doesn’t has every reason to stay on its own side of the line.
A client example: a usage-billing launch
The situation
A B2B analytics software company was moving from seat-based subscriptions to a platform fee plus metered API usage, with the launch set for the start of a quarter. Salesforce was the commercial front end, Zuora handled subscriptions, rating and billing, the product’s events supplied the usage, and NetSuite was the general ledger. The client’s Zuora implementation partner owned the catalog, rate plans, billing schedules and invoice templates, and we owned the data contracts and the flows around that configuration.
Who built what
The hardest question turned out to be what counted as billable usage. The raw application events included retries, internal test traffic and duplicate emissions, so we agreed on a billable-event schema – tenant ID, event ID, product meter, event time and quantity – and built an ingestion service that de-duplicated on the event ID, applied the agreed exclusions, and aggregated usage by each contract’s billing time zone and period. It kept a ledger of every event from the source through to its submission to Zuora. Events that arrived after a period had closed went through an adjustment process finance had agreed to, and were never slipped quietly into the closed period. On the commercial side, quote and order actions in Salesforce were mapped to Zuora subscription identities, and Zuora’s invoice and accounting output was reconciled against what NetSuite actually posted.
The outcome
Before launch, we ran parallel billing for two complete cycles, comparing expected and rated usage by tenant, plan and meter. We reconciled quantities and rated amounts separately, because matching event counts can still hide a pricing error. In the end, 99.9% of accepted usage units reconciled automatically, and the remainder sat in a documented exception queue.
Related reading
- Stripe integration beyond checkout
- Integration reconciliation reports: proving that two systems agree
- NetSuite Salesforce integration: keeping the CRM and the ERP in agreement
How eProxim works on Zuora programs
eProxim doesn’t run a Zuora practice. We work alongside the implementation partners who own the client, the roadmap and the platform configuration, and we build the technical layer between Zuora and everything it has to agree with – CRM to subscription, usage pipelines, revenue and general ledger integration, and book migrations.
Since 1997 that connective work has run underneath other firms’ client relationships in payments, telecom, billing and financial services. It includes a usage-mediation pipeline, built for a national mobile operator’s software partner, that rated 1.4 million events per second, and was designed so that duplicate or replayed records could never double-charge anyone. Idempotent processing, audit trails and a rollback path that exists before deployment are simply how we work by default, and none of them is an extra.
Partners usually start with one scoped integration, quoted at a fixed price with acceptance criteria. We can also embed named engineers in your team, or provide architecture ownership on its own, and the work can be delivered under your brand.
Bring us the Zuora integration work you’d prefer not to hire for. Take a look at our Zuora partner page, or start a partner conversation.
